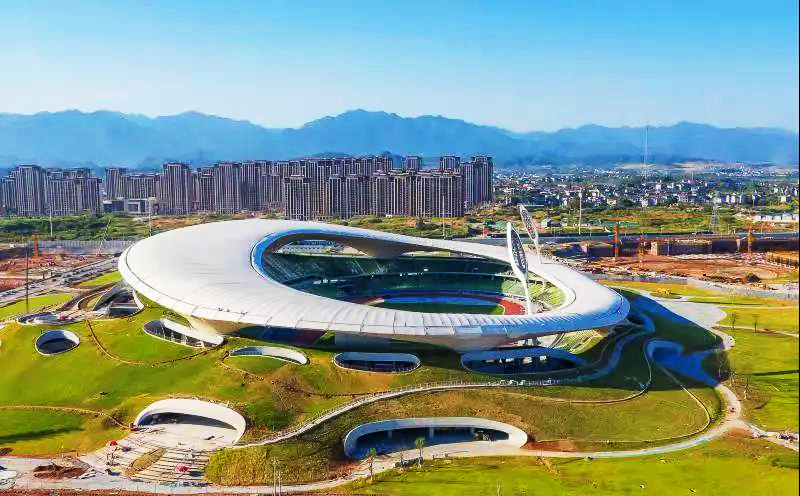

Quzhou Stadium does not present itself as a conventional stand-alone arena. Designed by MAD Architects as the centrepiece of a sports park covering almost 700,000 square metres, the 30,000-seat venue rises from a landscape of planted mounds, paths and public space. Its oval canopy appears to float above the seating bowl, while much of the supporting programme is absorbed into the land below.
That architectural ambition changes the way the running track should be understood. The red oval is not an isolated technical product placed inside a completed shell. It sits at the point where competition geometry, landscape design, roof structure, seating colours, event operations and construction sequencing all meet.

The main bowl belongs to a much larger public project
The sports park was conceived as more than a collection of competition buildings. Paths cross the grass-covered forms, and visitors can move through parts of the landscape even when no major event is taking place. The stadium is the largest element, but the visual idea depends on the whole site reading as one continuous terrain.
For the track contractor, this wider setting matters. Access routes, material storage and working areas have to coexist with landscape works and the construction of adjoining facilities. A delivery route that looks simple on a stadium plan may pass through areas needed by several other trades.
Inside the bowl, every colour has a job
The green seating and pale roof connect the interior to the landscape concept. The red running track provides the strongest continuous colour at field level and gives the bowl a precise athletic geometry. Any wandering line, uneven seam or contaminated patch would work against an interior that relies on clean, broad surfaces.
This is a project where visual quality and technical quality are difficult to separate. Secure seams, true curves and consistent texture are performance requirements, but they also protect the architect's intended image.

The track was installed within an active construction environment

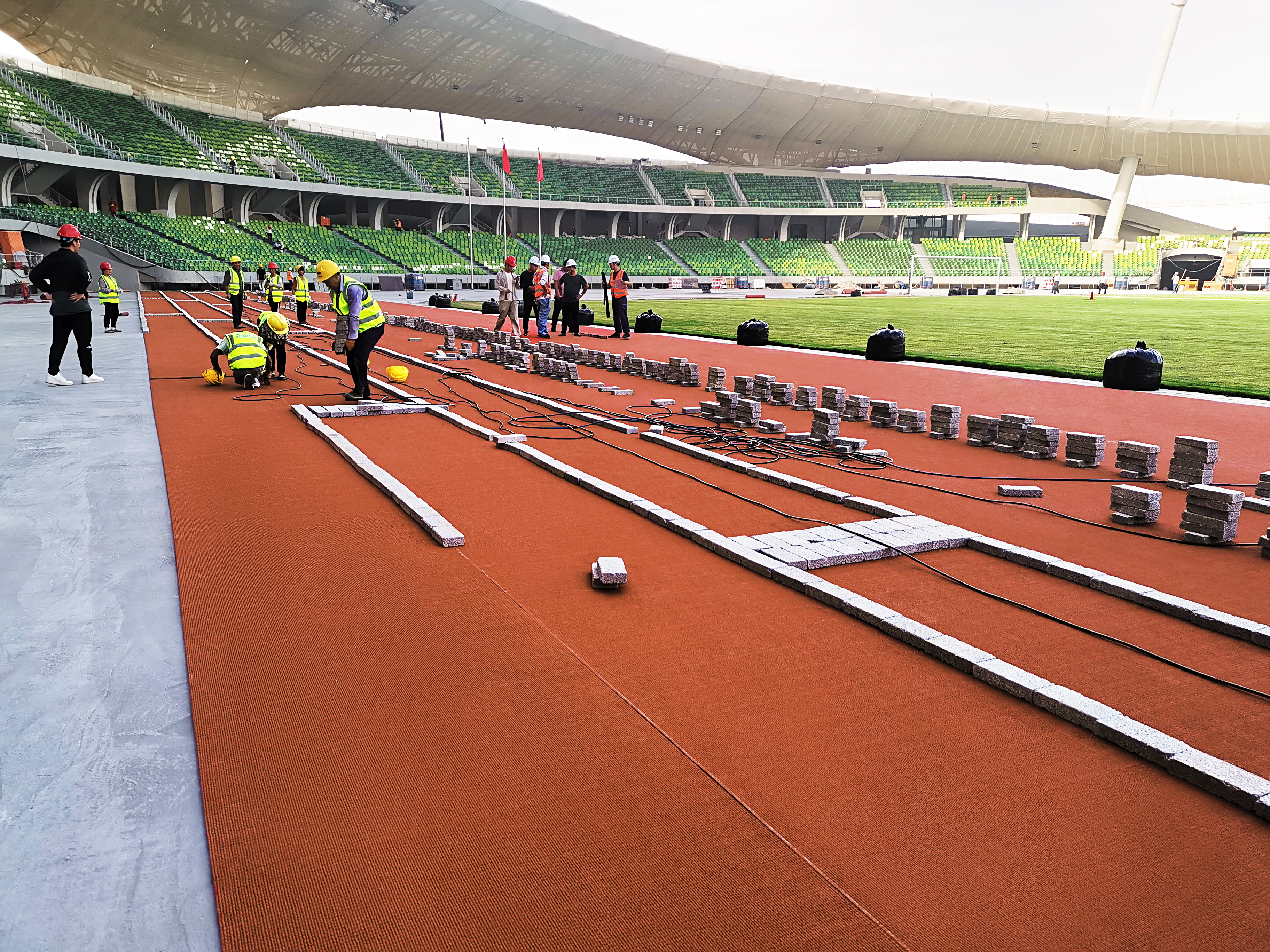

One site photograph is especially informative. The seating, turf and roof were already well advanced, while crews were still working across the track. Long rows of temporary weights follow the fresh seams, holding the material in position during bonding. Cables, tools and work zones are organised along the straight rather than scattered across the bowl.
It is a useful reminder that track installation rarely happens after every other contractor has left. The surface team works inside a nearly finished venue, where dust, access, overhead work and programme changes still have to be controlled.

A practical checkpoint table
Site checkpoint | Question for the project team | Why it matters |
Base release | Has the substrate been accepted for level, strength, cracks and moisture? | Bonding a roll over an unresolved base transfers the defect into the finished track. |
Work-zone release | Are dusty, wet or overhead activities separated from the track area? | Contamination can affect adhesion and permanently mark the surface. |
Material sequence | Are rolls identified and staged in laying order? | Correct sequencing reduces unnecessary handling and helps maintain visual continuity. |
Seam bonding | Can each section remain weighted and protected for the required time? | Early movement may disturb a joint before the bond has developed. |
Final protection | Are routes for equipment and other contractors clearly defined? | A completed surface is most vulnerable before formal handover. |
The straight establishes control; the curves test it
Long straights give the crew reference lines for alignment and seam spacing. Curves are less forgiving. Each roll follows a changing radius, and small positioning errors can accumulate across the track width. The installation plan should therefore identify control lines, roll direction and cutting strategy before full bonding begins.
Junctions around the inner kerb, drainage channel and field-event areas need the same attention. These are the places where water, movement and edge loading tend to concentrate. Clean detailing is not a decorative extra; it reduces the number of weak transitions in the system.
Seam work is a sequence, not a last-minute repair
The Quzhou construction image shows that seam control was treated as a dedicated operation. Material is positioned, the bond is activated, weights are applied and the area is kept stable. This methodical sequence is more reliable than trying to correct raised edges after the surrounding track has already been opened to traffic.
Once bonding is complete, the team checks surface continuity before line marking. The final white geometry should sit on a stable oval, not be used to disguise alignment problems beneath it.
Huadong Track manufactures prefabricated rubber running-track systems as factory-produced rolls. Its current range includes different material constructions and thickness options for competition, training and general stadium use. Moving surface formation into production helps control colour, texture and material structure before the rolls reach the venue.
Quzhou also shows the limit of that advantage. A consistent roll can still be poorly stored, laid on an unaccepted base or damaged by another trade. Product supply therefore has to connect with layout drawings, batch and roll management, installation guidance, adhesive planning and protection procedures.
For a landmark stadium, this joined-up approach is more valuable than a product description on its own. The manufacturer, installer and main contractor need a shared definition of when the work zone is ready and what must remain undisturbed after each section is laid.
The completed photographs show a clean red oval under a highly distinctive roof. That result does not need an exaggerated story about instant praise. In a public sports venue, the strongest outcome is often quieter: the track reads as part of the architecture, event preparation can proceed, and maintenance teams receive a surface with clear details and accessible records.

The contrast between the construction image and the finished view is useful. During installation, every seam is a separate task. At handover, those tasks should resolve into one continuous field. That is the real purpose of disciplined prefabricated track delivery.
VII. Conclusion
Quzhou Sports Campus is widely discussed for its landscape architecture, but the venue also offers a practical construction lesson. A visually ambitious stadium does not reduce the need for technical discipline; it exposes the quality of every interface more clearly.
Prefabricated running-track material brings controlled production into the project. The final result still depends on base release, logistics, setting-out, seam bonding, trade coordination and protection. At Quzhou, those ordinary-looking decisions were what allowed the track to sit comfortably inside an extraordinary building.
1.How large is Quzhou Sports Park?
Public architectural sources describe the complex as covering almost 700,000 square metres. The 30,000-seat stadium is its centrepiece.
2.Why is a prefabricated track relevant to a design-led stadium?
Factory production supports consistent colour, texture and material structure across a large visible surface. It also reduces the amount of surface-forming work carried out inside the nearly completed stadium.
3.What does weighting a seam achieve during installation?
Temporary weights keep the bonded material flat and stable while the adhesive develops. The exact method and duration should follow the approved system and site conditions.
4.Can the track be installed while other stadium work continues?
Yes, but only with controlled work zones. Dust, moisture, overhead activity, equipment routes and access across completed areas must be separated from the track operation.
