Substrate

Have you ever encountered a situation where a newly laid track quickly developed bulges, curled edges, or cracked seams?

The factory test reports for the rolls showed excellent indicators across the board, yet on-site, everything relied on the workers' intuition. No matter how good the material is, improper installation renders it useless. The decisive factor in whether a prefabricated rubber roll track can withstand professional competitions and last over a decade isn't at the factory – it’s in the on-site installation.

National standards like 《GB/T 14833-2020》, 《GB 36246-2018》, and IAAF facility construction standards are clearly defined. Every step – surveying, base layer treatment, adhesive mixing, roll laying, seam welding, edge finishing, and curing – has strict requirements. If any step is compromised, it leads to hollow areas, open seams, adhesive failure, and compromised athletic performance. Repair costs double, and the track may even fail annual inspections.

Below is a comprehensive process guide covering all procedures, environmental controls, quality assurance, and safety aspects, detailing exactly how the on-site work should be done.

I. Pre-Installation Base Layer Re-inspection and Meticulous Treatment

Adhesion between the roll and the base layer is the primary determinant of longevity. After the rolls arrive and undergo static settling, the base layer must be thoroughly re-inspected. Don't rely solely on the initial base construction being correct.

How to Check Core Indicators?
Place a 3-meter straightedge on the surface; deviations exceeding 3mm require rework. The longitudinal slope of the track should be ≤0.1%, and the transverse drainage slope ≤1.0% – these are IAAF minimum requirements. Construction is not permitted if the asphalt base hasn't cured for 28 days or the cement base for 7 days. Control the overall base moisture content below 5%. A simple field test: cover an area with plastic film for 24 hours; if no condensation appears underneath, it's acceptable. The base surface must be free of dusting, cracks, oil stains, and sharp particles. Patch local depressions with specialized repair mortar and seal fine cracks.

Don't skip the grinding and dust removal step, even if it seems troublesome. Use a dedicated grinder for overall surface grinding to remove laitance, protrusions, and residual impurities. Follow with an industrial vacuum cleaner, crossing over the area at least three times. Even a thin layer of dust remaining on the surface halves the adhesive bond strength – this is the primary cause of adhesive failure.

Apply the primer evenly across the entire base surface at a rate of about 0.15kg/㎡. Let it dry for over 8 hours at room temperature to form a sealing film. This film serves two purposes: enhancing the grip between the adhesive and the base, and blocking moisture rising from the ground below. This step is crucial in preventing future bubbling.




II. Measurement, Layout, and Pre-Layout of Rolls

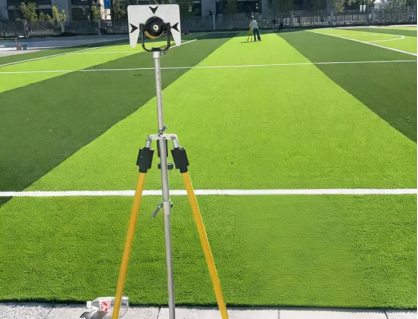

Inaccurate surveying ruins everything that follows. For a standard 400m track, individual lane width is 1.22 meters, and the overall tolerance for lane lines must be within 1mm. This cannot be achieved with a tape measure; a total station is required.

Professional survey technicians should mark all key reference points: track center, straight-curve transition points, lane lines, start lines, relay zones, and hurdle positions. Increase control points every 5 meters in curved sections to ensure precise radii. Keep detailed records of the markings for later acceptance checks.

Pre-lay the rolls following the sequence "straight sections first, then curves, from inside out". Plan seam locations in advance – transverse seams are strictly prohibited in main racing lanes, start zones, and hurdle areas. These areas endure high-frequency stress; placing seams here is asking for trouble. Unroll the rolls naturally to allow residual stress to release further. Check roll numbers and batches; mixing materials from different batches is strictly forbidden, as this is a common cause of color variation. Temporarily fix the pre-laid rolls and proceed to the adhesive application only after confirming overall dimensions and curvature.




III. Adhesive Preparation and Application

The adhesive is the bond between the roll and the base layer. Failure in any of the four steps – mixing ratio, stirring, application, or open-time – is unacceptable.

How to Control the Mixing Ratio?
You must use the two-component polyurethane adhesive supplied by the roll manufacturer. The standard ratio is usually Component A : Component B = 1:4. Mix only the amount needed for immediate use, ensuring it can be applied within 1 hour – the adhesive begins to cure after this time, rendering it useless if applied. Stir thoroughly and evenly; there should be no particles or separation. Never add thinners arbitrarily.

Apply the adhesive using a double-coating method – apply to both the base surface and the back of the roll. Choose the trowel notch size carefully: use a wide-notch trowel for asphalt bases and a narrow-notch trowel for cement bases. Maintain an overall application rate of 1.2~1.5kg/㎡, with extra adhesive applied in seam areas to ensure full coverage. Any missed or broken adhesive lines must be reworked immediately.

Don't rush to lay the rolls after applying the adhesive. Allow it to stand for 15~25 minutes. The optimal time for laying is when the adhesive feels tacky but doesn't string when touched lightly. Increase the open time in low temperatures/high humidity, and decrease it in high temperatures. Laying too soon means poor adhesion; laying too late means the roll won't stick – this judgment is based on experience.

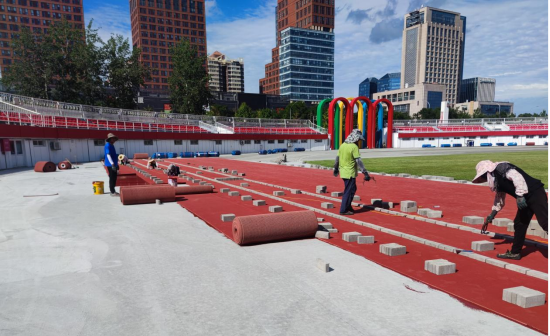

IV. Roll Laying, Air Removal, and Compaction

This is the core procedure. Techniques differ for straight and curved sections.

Straight Section Laying: Slowly lower the roll along the baseline, aligning it with the edge line. Do not pull or shift it during the process. Use a 50kg heavy rubber roller, rolling from the center of the roll outwards longitudinally, at a speed of about 1.5m/min, repeating the pass 3 times. This thoroughly expels air trapped between the roll and the base, preventing hollow areas. Leave a 5~8cm overlap with adjacent rolls for seam processing.

Curved Section Laying: Curves require a different approach; the roll cannot be bent forcibly. Allow it to naturally conform to the track's curvature, making fine adjustments on the inner side to ensure full contact with the curve. Curved sections endure greater stress than straights. In addition to standard rolling, use nails for temporary fixing at seams and edges to enhance stability.

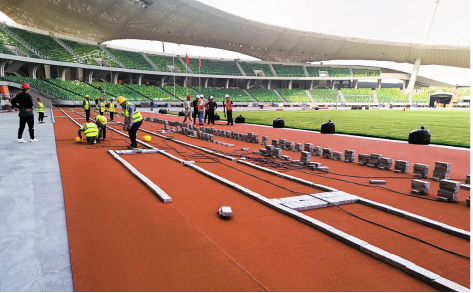

After laying, place weight blocks (e.g., bricks) at 50cm intervals along seams and edges, increasing the density of weighted points in curved areas. This is not an unnecessary step; roll shrinkage and edge curling often occur during this critical period.




V. Seam Treatment – The Core Quality Control Point

Seams on prefabricated rolls are the weakest points of the entire track. Waterproofing, wear resistance, and flatness all depend on the quality of the seams. The mainstream technique is hot-air welding, treating longitudinal and transverse seams separately.

Longitudinal Seams: Cut the overlapping rolls straight, leaving a 5mm weld gap. Control the hot-air welding machine temperature between 180~220℃, and the welding speed at 2~3m/min. Allow the weld to cool naturally, then trim excess rubber. The acceptance standard is simple: no visible height difference by eye and no protrusion felt by hand. The weld strength needs to reach over 90% of the roll's base material strength; otherwise, long-term wear resistance will be compromised.

Transverse Seams: Use the "pre-length and push" method. Leave a 3~5mm allowance on the roll, push the ends together firmly during splicing, fill with adhesive after cutting, and compact to ensure a gapless joint. Avoid concentrating multiple transverse seams in one area; stagger them instead.

After the seams cool, fill all joints with specialized sealant. This single step prevents rainwater from seeping through the gaps into the base layer.

VI. Edge and Special Detail Finishing

Problem areas often occur at the track's inner edge, drainage ditches, and interfaces with field event equipment. These require specific attention.

Track Inner Edge (Curb): Install the inner curb according to standards beforehand, with a height of 50~65mm. Use L-shaped aluminum alloy press strips at the junction between the roll and the curb, anchoring with expansion bolts at 30cm intervals. Fill the gap between the strip and the roll with elastic sealant. This effectively blocks water ingress and prevents edge curling.

Drainage Ditch Interface: Extend the roll to be flush with the ditch edge, creating a rounded edge and sealing it with waterproof press strips. This prevents drainage water from flowing back into the adhesive layer.

Field Event Area Interfaces: At transitions between the track and runways for long jump, high jump, or throwing areas, ensure a smooth edge transition with consistent height and no step changes. This is critical for athlete safety.

VII. Curing and Finished Product Protection

Laying the track doesn't mean it's ready for use. Inadequate curing negates all previous work.

Under normal temperature conditions, the overall curing period for the rolls is no less than 24 hours, with a complete curing period of 7 days. Assign personnel for daily inspections to immediately repair any curling, hollow areas, or seam openings detected. Don't delay repairs; problems become harder to fix over time.

No trampling or walking is allowed for the first 24 hours, and vehicular traffic, heavy material stacking, mechanical rolling, and sharp objects are prohibited for 7 days. Erect barriers and warning signs around the curing area; don't rely on workers' memory – physical isolation is most effective. Also, keep strong acids, alkalis, and colored liquids away to prevent surface contamination.

Extend the curing time appropriately in low-temperature/high-humidity environments. Protect open-air sites from rain with covers to prevent water from washing uncured adhesive layers.




VIII. Construction Safety and Site Management

As adhesives are chemical products, strictly prohibit all open flames on the construction site. Equip the site with adequate fire extinguishers, maintain good ventilation, and ensure construction personnel wear protective masks and gloves. Store adhesives in sealed containers away from high temperatures and chemical solvents.

Dispose of scrap materials and waste adhesive promptly. Keep the site clean and tidy. Handle construction wastewater and waste according to environmental regulations – don't wait for inspection issues to take corrective action.

Conclusion

Installing a prefabricated rubber roll track essentially involves the steps of "surveying → base treatment → adhesive application → laying → welding → edge finishing → curing". However, rigorous national standards and technical specifications underpin each of these steps.

A single oversight in one detail leads to hollow areas, curled edges, open seams, and water ingress later on. Repair costs escalate, and the track may fail competition acceptance or annual inspections, essentially rendering half the facility unusable.

Do not lay if the base is substandard. Do not construct if the environment is unsuitable. Do not proceed to the next step if the current procedure is incomplete. Adhering to these three red lines allows the roll's inherent performance, stability, and wear-resistant, environmentally friendly properties to truly shine. Only when athletic performance indicators like shock absorption and vertical deformation meet standards, and the track remains problem-free for a decade, can it truly be called precision paving.

Frequently Asked Questions (FAQs)

Q1: What causes widespread hollow areas and bubbles after laying, and how should they be handled?
The causes are typically fourfold: incomplete dust removal from the base; insufficient rolling to expel air; high base moisture content causing rising moisture; or uneven/missed adhesive application. Minor localized bubbles can be repaired by micro-drilling, injecting adhesive, and re-weighting. For large-scale hollow areas, the only solution is to cut out and relay the section. Thorough dust removal, moisture content checks, and multi-pass rolling during construction are the best preventative measures.

Q2: How can frequent curling and seam opening on curves be prevented and fixed?
Curves have significant radii and experience more pronounced thermal expansion/contraction. Preventive measures include: natural, tension-free laying of rolls in curves; increasing the number of weighted points and nail fixings; using edge press strips plus sealant for double-fastening; and avoiding construction during periods of large diurnal temperature fluctuations. For already curled edges, lift the edge, apply fresh adhesive, re-weight during curing, and re-seal.

Q3: What if the applied adhesive doesn't cure, or cures too quickly?
Curing slows significantly at temperatures below 10℃ or in high humidity. Incorrect mixing ratios or insufficient stirring can lead to localized non-curing. Mixing too much adhesive at once that exceeds its pot life leads to premature curing. Solutions: construct within a 10℃~35℃ range, use the manufacturer's specified ratio, mix only what's needed for immediate use, and control batches to be applied within 1 hour. In low temperatures, a manufacturer-approved accelerator may be added if specified.

Q4: How can seam water seepage and cracking be resolved?
Seepage and cracking typically result from incomplete stress release of the rolls before laying, improper hot-melt welding (e.g., relying only on adhesive), leading to adhesive aging and separation. Simultaneously, high base moisture content, existing cracks, insufficient drainage slope, and thermal/mechanical stresses continuously pull at the seams. For minor cracks, cut a groove, clean it, fill with elastic sealant, and apply a waterproofing layer over the surface. For severe gaps, curling, or hollowing, remove the damaged roll section, dry and repair the base, then re-lay with proper overlapping and hot-melt welding, adding buffer layers and double sealing. Prevention remains the priority: ensure stress release, adhere to bonding procedures, and ensure adequate base drainage.

Q5: How long after laying can line marking and equipment installation be done?
Wait at least 72 hours for the overall roll adhesive and hot-melt seams to fully cure, during which time walking and moisture exposure are prohibited. Extend this to over 4 days in low-temperature or rainy weather. After the curing period, conduct a full inspection – only if no hollow areas, seam openings, or seepage are found should line marking proceed. Allow the marking paint to dry for 24 hours after application. Equipment installation is best carried out 7 days after laying to prevent heavy objects from stressing un-stabilized seams. Use soft pads under equipment bases to distribute pressure and prevent local deformation/cracking.

Q6: How should adhesive open time be adjusted for different temperatures?
20~25℃ is the optimum construction temperature, with an open time of 15~25 minutes. Above 30℃, the adhesive volatilizes faster, reduce open time to 10~15 minutes. Below 15℃, the adhesive's activity decreases; extend open time to 25~35 minutes. Always rely on the "tacky but no stringing when touched" rule.

Q7: What to do if it rains suddenly during construction?
Immediately stop all adhesive application and laying operations. Completely cover the laid area with waterproof tarpaulins, weighing down the edges securely to prevent rainwater ingress. If rainwater has contacted uncured adhesive, lift the roll, thoroughly clean the affected adhesive layer, and re-apply adhesive before re-laying. If only the surface got wet and the adhesive layer remains unaffected, allow ventilation/drying, check adhesion, and proceed with curing if acceptable.
